Convert Your Garage to an ADU: A Complete U.S. Guide

Discover how to convert your garage to an ADU with this complete U.S. guide. Maximize property value and living space easily!
Couple reviewing garage to ADU conversion plans

Yes, in most U.S. jurisdictions you can convert a garage to an ADU — and for many homeowners, it’s the fastest, lowest-cost path to adding a rentable or livable unit on their property. The short checklist to run right now: confirm your parcel is ADU-eligible with your local planning department, assess your slab condition and thickness, check whether your electrical service can support a full dwelling load, and verify your sewer lateral has capacity for an additional unit.

Cost-wise, a basic 1-car studio garage conversion typically costs $100,000–$140,000 in California, while a 2-car garage finished as a 1-bedroom generally runs $130,000–$170,000. National figures trend somewhat lower, with most all-in costs falling between $100,000 and $175,000 depending on region, finish level, and structural needs. Coastal metros push higher; inland markets like southern Utah tend to come in more competitively. Timeline from permit application to occupancy generally runs several months in most jurisdictions, though permit-backlogged cities can stretch that.

If any item on the checklist is uncertain — especially the slab or sewer — book a parcel-level feasibility review before spending money on design. That single step prevents the most expensive surprises.

Quick feasibility checklist:

  • Confirm ADU eligibility on your specific parcel (zoning, overlay districts, lot size minimums)
  • Check slab thickness, flatness, and whether a vapor barrier exists
  • Verify electrical service amperage (100A minimum for a modern ADU; 200A preferred)
  • Scope the sewer lateral for capacity and condition
  • Note garage age: pre-1970 structures carry higher retrofit risk

Table of Contents

How does the garage-to-ADU conversion process work, step by step?

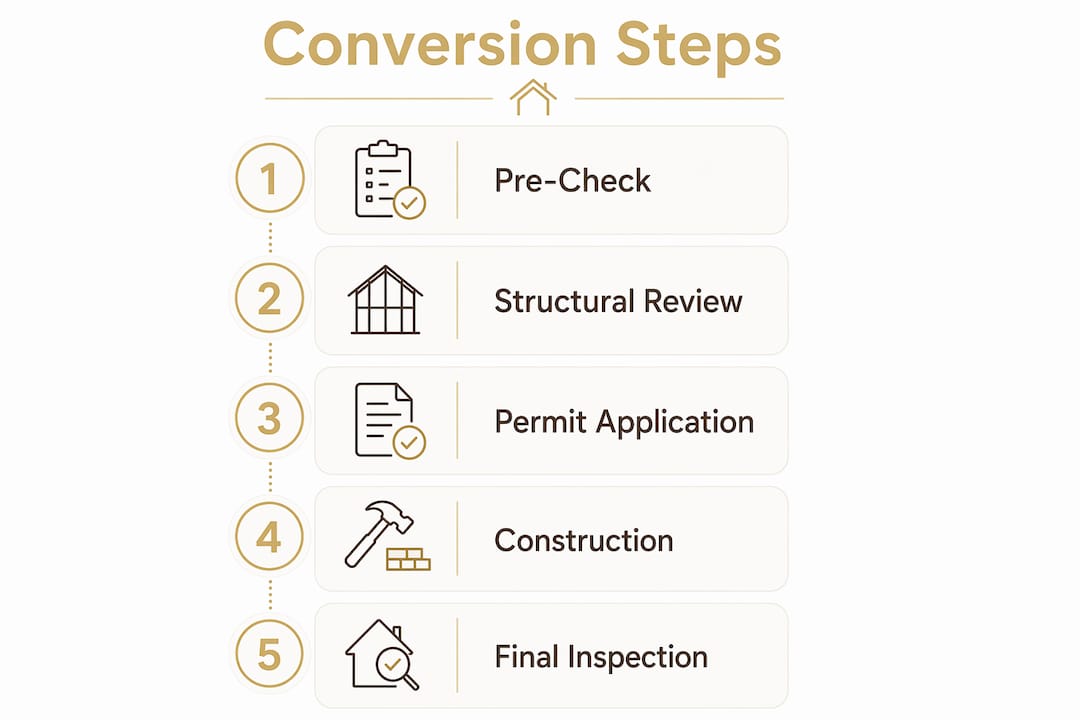

Converting a garage into a livable ADU follows a predictable six-phase arc. Where time and money concentrate depends heavily on what the structure reveals once you look closely.

  1. Feasibility assessment generally takes a few weeks. You or a contractor evaluate the slab, framing, roof, ceiling height, electrical service, and sewer access. A structural engineer gets involved if anything looks marginal. This phase costs relatively little but prevents enormous downstream surprises.

  2. Design and engineering typically require several weeks. An architect or design-build firm produces construction drawings. If the structure needs shear panels, foundation bolting, or a new header at the old garage-door opening, a structural engineer stamps those details. This is also when energy compliance (Title 24 in California, equivalent codes elsewhere) gets calculated.

  3. Permit submittal and plan check usually take a few months. You submit drawings to the building department. Plan checkers review for zoning compliance, building code, energy, fire separation, and egress. Correction rounds are common — budget two to three rounds in busy jurisdictions. Pre-submittal meetings with the building department, when offered, compress this phase significantly.

  4. Construction commonly takes a few months. Slab prep, framing modifications, rough mechanical/electrical/plumbing, insulation, drywall, finishes, and fixture installation happen in sequence. Each trade phase requires an inspection before the next begins.

  5. Inspections and corrections. Inspectors visit at foundation/slab, rough framing, rough MEP, insulation, drywall, and final stages. Correction notices add days or weeks; having a contractor who has pulled permits in your jurisdiction before reduces these.

  6. Certificate of occupancy. Once all inspections pass and the unit matches approved plans, the building department issues a certificate of occupancy. You can legally rent or occupy the space at that point.

Homeowners can handle pre-check calls to the planning department and utility capacity inquiries themselves. Engineering, permit preparation, and all construction work should go to licensed professionals.


Is your garage’s structure actually ready for an ADU conversion?

Garage shells were built to store cars, not house people. That distinction matters more than most homeowners expect when they start pricing a conversion.

Physical assessment checklist:

  • Slab thickness and condition. Most garage slabs are 4 inches thick, sometimes less, and often lack a vapor barrier. Habitable spaces typically need a moisture barrier and may need leveling or full slab replacement if cracking or settlement is present.
  • Footing depth. Shallow footings that worked for a garage may not meet residential code without reinforcement.
  • Roof framing and ceiling height. Habitable rooms generally require a minimum finished ceiling height of 7’0"; bathrooms can clear at 6’8". Low-pitch roofs with collar ties can make this tight.
  • Signs of settlement or cracking. Step cracks at corners, doors that stick, or visible slab heave all signal foundation movement worth investigating before you design around it.
  • Shear and lateral resistance. Garages often have large openings and minimal shear walls. Converting to a residence typically requires adding engineered shear panels, especially in seismic zones.
  • Permit history. Pull the permit history for your garage from the building department. An unpermitted garage creates complications when you try to permit the ADU conversion.

When to call a structural engineer: any time the slab shows significant cracking, the ceiling height is borderline, the garage predates 1970, or you’re in a seismic or high-wind zone. Ask them specifically about foundation retrofit thresholds, required shear panel locations, and whether the existing framing can carry the new roof loads after modifications.

Pro Tip: Schedule a pre-submittal meeting with your local building department before finalizing your design. Inspectors will tell you how they plan to treat existing field conditions during plan check — that conversation can eliminate entire correction rounds and save weeks of back-and-forth.

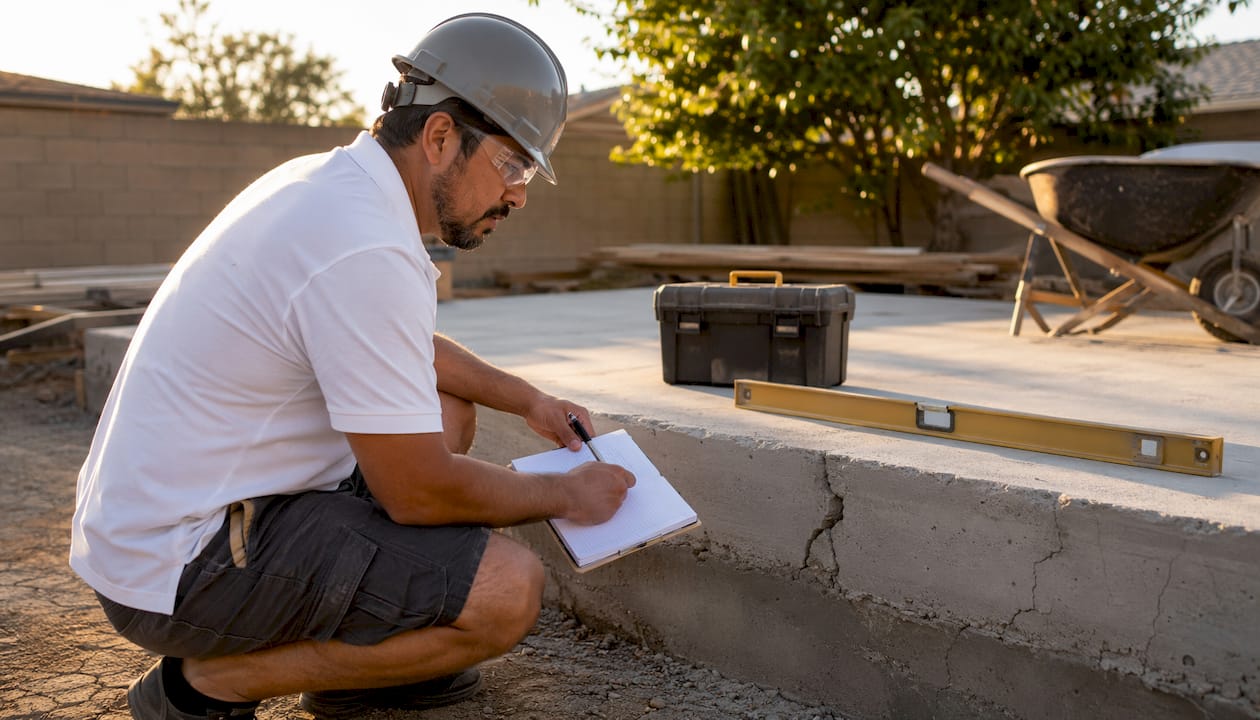

Engineer inspecting garage concrete slab cracks

Pre-1970 garages commonly trigger structural retrofits that can add notable costs to the budget. The slab is a major unknown: thin slabs without vapor barriers may need leveling, vapor mitigation, or full foundation work — interventions that are disruptive once finishes are installed. Get the slab evaluated before design begins, not after.

A useful reference for understanding foundation retrofit options can help you frame the right questions for your structural engineer.


What permits and building codes apply to a garage ADU conversion?

Every garage-to-ADU conversion in the U.S. requires permits. No exceptions worth taking.

Confirming parcel eligibility:

Start with your local planning department, not Google. Zoning overlays, historic districts, lot-size minimums, and owner-occupancy requirements vary by city and county. California’s statewide ADU law, codified in Government Code section 66323, mandates that local agencies allow at least one converted ADU on single-family lots — but local standards still govern setbacks, height, and design in many cases. Other states have their own frameworks; check your jurisdiction directly.

Permits typically required:

  • Building permit (structural and architectural work)
  • Electrical permit
  • Plumbing permit
  • Mechanical permit
  • Energy compliance report (Title 24 in California; equivalent energy codes apply in other states)

Key code items that affect your design:

  • Minimum finished ceiling height of 7’0" for habitable rooms; 6’8" for bathrooms
  • Emergency egress windows required for sleeping rooms (minimum net clear opening area applies)
  • Fire separation requirements for attached conversions (typically a 1-hour fire-rated wall between the ADU and the primary dwelling’s garage space)
  • Insulation and energy compliance measures, which can require new wall assemblies and window upgrades
  • Plumbing tie-in rules, including whether a separate sewer lateral is required

Inspection sequence (based on LA County’s ADU inspection process as a representative example): underground utilities, foundation/slab, rough framing, rough MEP, insulation, drywall/shower pan, and final. Your jurisdiction’s sequence may vary, but the logic is the same: each phase must be signed off before the next is covered.

Warning about unpermitted conversions: Skipping permits creates serious long-term exposure. Unpermitted work can block a home sale (disclosure requirements apply in most states), void your homeowner’s insurance coverage for the converted space, and trigger mandatory retrofit expenses when the work is eventually discovered. The cost of doing it right — permits, engineering, inspections — is consistently lower than retroactive fixes.


How much does it cost to convert a garage to an ADU, and how do you finance it?

Costs vary by region, structure condition, and finish level, but a detailed breakdown includes costs for structure/foundation, insulation/drywall, electrical, plumbing, HVAC, windows/doors, kitchen, bathroom, and design/engineering/permits. Sources include ADU Pilot cost data and ADUscale regional figures.

Homeowner reviewing ADU financing paperwork overhead

Typical national all-in costs generally range from $100,000 to $175,000. In California, a basic 1-car studio conversion is usually $100,000–$140,000, while a 2-car 1-bedroom conversion typically costs $130,000–$170,000; premium finishes or extensive structural work increase costs further.

Hidden costs homeowners frequently miss:

  • Sewer lateral upgrade: $15,000–$30,000 when the existing lateral lacks capacity or fails a scope inspection
  • Trenching a detached garage to connect sewer or water, which can require a street cut or long runs under landscaping
  • Electrical service upgrade from 100A to 200A at the main panel
  • Engineered shear panels required by seismic or wind codes
  • Energy compliance measures (cool roofing, new window assemblies, insulation upgrades)

For Utah-specific pricing, the ADU cost guide for Utah covers regional ranges for detached, garage, and casita builds.

Budget sizing example:

A studio conversion in a post-1980 attached garage with a good slab, existing 200A service, and a short sewer run might land at $110,000–$130,000 all-in. A 2-car detached garage built before 1970 with a thin slab, 100A service, and a long sewer run to the main could reach $180,000–$220,000 once all the structural and utility work is priced. Budget a 10–20% contingency on top of your contractor’s bid — 20% for pre-1970 structures.

Financing options:

  • Home equity loan or HELOC: Fixed or variable rate against existing equity; straightforward for homeowners with significant equity built up.
  • Cash-out refinance: Replaces your existing mortgage with a larger one; works well when rates are favorable.
  • Construction-to-permanent loan: Funds construction draws, then converts to a standard mortgage; useful for larger scopes.
  • FHA 203(k) renovation loan: Allows financing of purchase and renovation together; more paperwork but accessible for buyers adding an ADU at purchase.
  • Personal line of credit: Higher rates but no equity required; reasonable for smaller projects or gap financing.

ADU financing programs vary by state and lender. The ADU financing overview at Texas FHA covers loan program considerations worth reviewing before you talk to a lender.

Insurance and property taxes: Adding a permitted ADU will likely trigger a reassessment of the converted portion of your property. The primary dwelling’s assessed value typically stays protected under Proposition 13 in California; other states handle this differently. Update your homeowner’s policy before occupancy — the converted space needs to be listed as a dwelling unit, not a garage. For a detailed look at how ADUs affect assessed value, the ADU property tax guide walks through the mechanics. A completed ADU can also add measurable value to your home’s resale price, particularly in markets with housing shortages.


How do you design a garage ADU that actually feels like a home?

A 400-square-foot garage can feel cramped or surprisingly livable depending almost entirely on layout decisions made before framing starts.

Layout templates that work:

  • 1-car garage (roughly 12’ x 20’): Best suited to a studio with a combined living/sleeping area, compact kitchen, and wet bath. Murphy beds or a lofted sleeping area (if ceiling height allows) recover floor space.
  • 2-car garage (roughly 20’ x 20’ or 22’ x 22’): Comfortably fits a 1-bedroom with a separate kitchen, living area, and full bath. A tandem layout (one car deep, two wide) can accommodate a small second bedroom.

Handling the garage door opening: The old door opening is your biggest design asset. Options include infilling with a framed wall that incorporates large windows and a glass door (maximizes light), or installing a folding glass wall system that opens the unit to a patio. Either approach transforms the feel of the space more than any finish choice.

Utilities checklist:

  • Sewer tie-in: confirm whether you can connect to the existing house lateral or need a separate run to the main
  • Electrical: most ADUs need at least a 100A subpanel; if the main house panel is already near capacity, a full service upgrade to 200A may be required
  • HVAC: a mini-split heat pump is the standard choice — no ductwork, efficient, and easy to zone; budget $5,000–$15,000 installed
  • Water heater: a tankless unit mounted on an exterior wall saves floor space and is code-compliant in most jurisdictions
  • Meter separation: some jurisdictions require or allow a separate utility meter for a rental ADU; check with your utility provider early

Accessibility quick wins: Zero-step entry from the exterior (achievable by grading the approach), 36-inch interior doorways, and a curbless shower in the bathroom add almost nothing to cost when planned from the start. They matter for aging-in-place use cases and can be required for certain rental certification programs.

Pro Tip: Paint the ceiling white and run continuous LVP flooring wall to wall — no transitions, no area rugs breaking up the sightlines. Those two choices make a small garage ADU read as significantly larger than it measures.


What happens during construction, and how long does it take?

Once permits are approved, construction follows a predictable sequence. Deviating from it — usually by trying to skip ahead — is what generates correction notices and delays.

Construction phase checklist:

  • Slab preparation: moisture testing, vapor barrier installation, leveling compound if needed, and any foundation bolting or footing work
  • Framing modifications: infill the garage door opening, add or relocate windows, install headers, add shear panels per engineering
  • Rough MEP: rough electrical, plumbing drain/supply, and mechanical (mini-split linesets, ventilation)
  • Insulation: walls, ceiling, and any floor assembly required by energy compliance
  • Drywall and waterproofing: hang, tape, and finish; shower pan and tile waterproofing inspected before tile
  • Finishes: flooring, cabinetry, countertops, fixtures, doors, trim, and paint
  • Final inspections and certificate of occupancy

Realistic scheduling:

  1. Plan check approval: typically a period of a few months, varying widely by jurisdiction backlog
  2. Construction: a few months after permit issuance
  3. Full project: commonly several months from first permit submittal to occupancy in California; similar in other active markets

Permit-backlogged jurisdictions can push the full timeline to 12 months or more. For a detailed breakdown of what drives ADU timelines, the ADU timeline guide covers phase-by-phase scheduling.

Coordinating subcontractors: Rough MEP trades (electrician, plumber, HVAC installer) need to be sequenced so they don’t block each other. Framing must be complete before rough electrical begins; plumbing rough-in typically happens alongside electrical. A general contractor or design-build firm manages this sequencing; self-managing it as an owner-builder is where most schedule blowouts originate.


Who should you hire, and what should the contract say?

The contractor you choose determines whether your project comes in on budget and on schedule, or becomes a cautionary story.

Types of providers:

  • Architect plus general contractor: You hire a designer separately, then bid the plans to GCs. More control over each relationship; more coordination work for you.
  • Design-build firm: One entity handles design, engineering coordination, permitting, and construction. Faster communication, clearer accountability, and typically fewer change orders because the same team that designed it is building it.

Vetting checklist:

  • Valid state contractor’s license (verify on your state licensing board’s website)
  • Documented ADU experience in your specific jurisdiction — ask for permit numbers from recent projects you can verify
  • Proof of general liability and workers’ compensation insurance
  • References from ADU or garage conversion projects completed in the last two years
  • Change-order history: ask how many change orders their last three projects generated and what caused them

Essential contract elements:

  • Detailed scope of work (not “garage conversion” — specific line items)
  • Fixed-price or cost-plus structure with a clear cap
  • Milestone-based payment schedule (never pay more than 10% upfront in most states)
  • Written change-order process with pricing before work begins
  • Completion timeline with defined milestones
  • Warranty language (minimum 1 year on workmanship; longer on structural)
  • Insurance and indemnity terms

Red flags: A contractor who suggests skipping permits to “save time,” can’t provide permit numbers from previous ADU projects, asks for more than 10–15% upfront, or gives a verbal scope with no written contract is a project risk you don’t need.

Prestigioushome brings structural engineer coordination, permit management, 3D renderings, and local jurisdiction experience in Washington and Iron Counties to every project. That combination — design and construction under one roof — is what keeps ADU projects from generating the change orders and delays that plague split-vendor approaches.


Should you convert your garage, build a new ADU, or add a room instead?

The right answer depends on your budget, your garage’s condition, and how much yard you’re willing to give up.

Decision matrix:

Factor Garage conversion New detached ADU Room addition
Cost Lowest (reuses shell) Highest (new foundation, framing) Mid-range
Timeline Shortest Longest Mid-range
Yard impact None Significant Minimal
Design flexibility Limited by existing shell Highest Moderate
Hidden-risk exposure High (slab, sewer, electrical) Low (new construction) Low to moderate

Pros and cons in brief:

Garage conversion:

  • Lower cost when the shell is in good condition
  • No new footprint; preserves yard and parking (converted parking spaces don’t need to be replaced in many jurisdictions)
  • Structural unknowns can erode the cost advantage quickly

New detached ADU:

  • Maximum design flexibility and modern construction standards throughout
  • Higher upfront cost, but fewer surprises
  • Requires yard space and may trigger setback and lot-coverage limits

Room addition:

  • Stays attached to the primary dwelling; simpler utility connections
  • Limited to what the existing structure can support
  • Doesn’t produce a fully independent unit in most cases

For a side-by-side breakdown of costs, permits, and privacy trade-offs, the ADU vs. room addition comparison covers the decision in detail.

Rule of thumb: Conversion makes sense when your garage was built after 1970, the slab is in good condition, your budget is under $200,000, and you want to preserve yard space. If the garage has significant structural issues and retrofit costs approach new-construction per-square-foot costs — roughly $40,000–$80,000 in avoided savings — building new is often the smarter financial decision.


What are the biggest risks, and how do you manage them?

Garage conversions fail budgets for predictable reasons. Knowing them in advance is most of the mitigation.

Evidence-based risk list:

  • Unpermitted work: The most cited project failure. Voids insurance, blocks sales, and creates mandatory retrofit costs that typically exceed what the permits would have cost originally.
  • Pre-1970 framing and foundation: Older structures frequently need shear panel upgrades, foundation bolting, and slab work that weren’t visible at the start.
  • Sewer lateral capacity: A failed sewer scope can add $15,000–$30,000 to the budget. Detached garages may require trenching under landscaping or hardscape, and sometimes a street encroachment permit.
  • Electrical service: A house running on 100A service with a full ADU load added often requires a main panel upgrade — a cost that surfaces after design is complete if no one checked early.

Mitigation steps:

  • Order a sewer scope before design begins
  • Have a structural engineer evaluate the slab and framing before finalizing the budget
  • Pull the electrical service size from your utility bill or meter base before the first contractor meeting
  • Schedule a pre-submittal meeting with the building department — skipping this step is one of the most common and costly mistakes in ADU projects, because it’s where inspectors tell you how they’ll treat existing field conditions before drywall covers everything
  • Budget a 15–20% contingency for pre-1970 structures; 10% for post-1980 garages in good condition

Pro Tip: Ask your contractor to price both the sewer lateral upgrade and the street encroachment permit in the initial bid, even if the scope inspection looks clean. If the lateral is marginal, you want that number before you sign a contract, not after demolition starts.

A composite scenario that plays out regularly: a homeowner budgets $140,000 for a 1-car studio conversion on a 1965 garage. The sewer scope reveals a cracked lateral requiring full replacement ($22,000). The slab probe shows no vapor barrier and uneven thickness requiring leveling and a new moisture barrier ($12,000). With a 15% contingency already built in, the project lands at $185,000 — still viable, but only because the engineer was hired before design was finalized, which allowed the budget to be reset before contracts were signed.


What should you do in the next 30, 90, and 180 days?

If the feasibility checklist from the opening section came back clean, here’s how to move forward without losing momentum.

Verdict guidance: A post-1970 garage with a documented permit history, a solid slab, 200A electrical service, and a short sewer run to the main is a strong conversion candidate. A pre-1970 garage with an unknown slab, 100A service, and a detached position requiring a long sewer run should be evaluated by a structural engineer and a plumber before any design dollars are spent.

Prioritized action checklist:

Next 30 days:

  • Call your local planning department to confirm ADU eligibility on your parcel
  • Pull the permit history for your garage from the building department
  • Gather recent utility bills to confirm your electrical service amperage
  • Order a sewer scope inspection

Next 90 days:

  • Hire a structural engineer for a slab and framing assessment if any red flags surfaced
  • Get two to three bids from licensed contractors or design-build firms with documented ADU experience
  • Attend a pre-submittal meeting with the building department
  • Finalize your budget, including a realistic contingency

Next 180 days:

  • Execute a contract with your chosen contractor
  • Submit permit applications with completed architectural and engineering drawings
  • Confirm your homeowner’s insurance covers the project during construction

Minimum documentation to gather before your first contractor meeting:

  • Lot map or assessor’s parcel map (available from your county assessor’s website)
  • Original garage permit, if available
  • Recent utility bills showing electrical service size
  • Any HOA CC&Rs that might restrict ADU construction

Key Takeaways

Converting a garage to an ADU is the lowest-cost ADU path when the shell is in good condition, but slab, sewer, and electrical unknowns can close that cost gap fast if they’re not identified before design begins.

Point Details
Cost range All-in costs typically run $100,000–$175,000 nationally; pre-1970 structures can push $180,000–$220,000 with structural and sewer work.
Biggest risk drivers Slab condition, sewer lateral capacity, and electrical service size are the three most common budget-busters — scope all three before design.
Permit non-negotiable Unpermitted conversions void insurance, block home sales, and trigger mandatory retrofit costs; always pull full permits.
First action Confirm parcel ADU eligibility with your local planning department and order a sewer scope before spending money on design.
Prestigioushome Prestigioushome manages feasibility, engineering coordination, permits, and design-build construction for ADU projects in Washington and Iron Counties, Utah.

The part most guides skip over

Most ADU content focuses on the exciting part — layouts, finishes, rental income projections. What gets underplayed is how often the structural and utility reality of an existing garage shell rewrites the project economics entirely.

The homeowners who come out ahead on garage conversions are the ones who treat the feasibility phase as the real project, not a formality before the fun starts. Getting a structural engineer on-site before a single design dollar is spent, scoping the sewer, and sitting down with a building department plan checker — those three steps cost a few hundred to a few thousand dollars and routinely save tens of thousands in change orders and redesigns.

There’s also a tendency to underestimate how much the permit process protects you. Unpermitted conversions feel like a shortcut until the house goes on the market or a pipe fails and the insurance company asks for the permit number. The “cost of doing it right” argument isn’t just about compliance — it’s about the long-term value of the improvement actually being recognized by lenders, buyers, and insurers.

In Washington and Iron Counties, Utah, projects that go smoothly often result from homeowners committing to a feasibility-first approach before design. That sequence — evaluate, then design, then build — helps separate on-budget projects from cautionary stories.


Prestigioushome handles the hard parts of a garage ADU conversion

Turning a garage into a livable ADU involves more moving parts than most homeowners expect: structural assessments, engineering coordination, permit management across multiple agencies, and construction sequencing that keeps inspections on track. Prestigioushome handles all of it under one roof for homeowners in Washington and Iron Counties, Utah.

Prestigioushome

The process starts with a parcel-level feasibility review — slab condition, sewer access, electrical service, and local zoning eligibility — so you get a realistic budget range before any design work begins. From there, the team coordinates structural engineering, produces 3D renderings so you can see the finished space before framing starts, and manages permit submittals through to certificate of occupancy. No handoffs between a designer who’s done and a contractor who wasn’t in the room.

If your project scope extends beyond the garage — a kitchen remodel in the main house, a room addition, or a larger renovation — the full home remodeling services page covers what’s available. For homeowners weighing a garage conversion against a new custom build, the custom home building guide explains the process and what to expect. To get started, reach out to Prestigioushome directly for an initial consultation and rough budget estimate for your specific parcel.

Infographic showing garage to ADU conversion steps


Useful sources for further research

  • California HCD ADU Handbook (March 2026): The authoritative state-level guide to California ADU law, including what local agencies can and cannot require. Essential reading for California homeowners; useful as a framework reference for homeowners in other states.

  • LA County Building and Safety — Garage Conversion to ADU Program: Step-by-step permit process, pre-construction meeting requirements, and inspection checklists for LA County. A detailed model of what a well-structured local ADU program looks like; useful for homeowners in any jurisdiction to understand what a thorough process involves.

  • California Energy Commission — 2025 Energy Code ADU Guidance: Covers energy compliance scenarios for attached, detached, and converted ADUs under California’s Title 24. Title 24 applies only in California, but other states have equivalent energy codes — this document illustrates the compliance categories homeowners will encounter.

  • ADUscale — Garage Conversion ADU Cost and Process Guide: Detailed cost breakdowns, retrofit risk factors, and process guidance for California garage conversions. Strong on the structural and financial trade-offs between conversion and new construction.

  • ADU Pilot — Garage Conversion Requirements and Cost Guide: Line-item cost ranges, code requirements, and ceiling-height and egress standards. Useful for building a preliminary budget and understanding the code minimums your design must meet.

Conclusion

The construction industry is at the cusp of a technological revolution. Embracing these trends not only enhances efficiency and sustainability but also opens up new possibilities for innovation. Whether you’re planning a project or exploring career opportunities in construction, understanding these trends will keep you ahead of the curve.
