Avoid Fines and Delays: Utah Building Permits and 3–10 Day Reviews

Utah homeowners: which projects need a permit, how to use Citizen Access or ProjectDox, expect 3–10 day reviews, and verify contractors before you build.
Residential permit plans beside Utah construction site

Yes. Nearly every new home, addition, or major system upgrade in Utah requires a building permit, and skipping that step risks fines, forced removal of finished work, and an unusable Certificate of Occupancy. Your first move: confirm which city or county has jurisdiction over your address, then start an application through that jurisdiction’s online portal or call the planning counter directly. Expect a review window of several working days for a standard residential project.


TL;DR:

  • Most Utah jurisdictions require permits for new homes, additions, accessory structures, pools, and any work on vital systems to ensure code compliance.
  • Permits are applied for online through jurisdiction-specific portals, with delays caused mainly by incomplete or incorrect submissions like non-PDF files or missing documentation.
  • The review process typically takes 3 to 10 days for standard projects, but complex builds may require 30 to 45 days once revisions are added.
  • Inspections are mandatory at multiple stages, including foundation, framing, and system rough-ins, and missing them can delay obtaining the Certificate of Occupancy.
  • Verifying contractor licenses and scheduling inspections early can prevent delays, with owner-builders assuming full responsibility for code compliance.

Table of Contents

Which Projects Need a Building Permit in Utah?

New single-family homes always need a permit. So do additions, basement finishes, and detached structures over a certain size, even when the work looks minor from the driveway. Most jurisdictions also require a permit for anything touching gas lines, electrical panels, mechanical systems, or plumbing, along with pools and spas exceeding a specific local size threshold. Davis County and comparable Utah building departments list these categories as standard permit triggers, and the pattern holds statewide even though exact thresholds shift from one jurisdiction to the next.

Here’s where homeowners get tripped up: local building departments have discretion to require a permit for projects that seem borderline, like a large shed, a retaining wall past a certain height, or a re-roof that changes structural framing. Never assume a project is too small to count.

  • New home construction, room additions, and basement or garage finishes
  • Accessory structures (sheds, casitas, detached garages) above the local size threshold
  • Swimming pools, spas, and hot tubs
  • Any work on gas, electrical, mechanical, or plumbing systems
  • Structural changes to roofs, load-bearing walls, or foundations

Owner-builders can pull their own permits in many counties, but doing so shifts full responsibility for code compliance and inspection scheduling onto you. A licensed contractor typically handles that burden as part of the build.

How Do You Apply for a Building Permit in Utah?

Utah’s application process runs almost entirely online now, and most delays come from skipping a step rather than the review itself.

  1. Confirm your jurisdiction and portal. Cities like Salt Lake City run applications through the Citizen Access Portal, while other municipalities use ProjectDox or a county-specific email submission process. Call ahead if you’re unsure which system applies to your address.
  2. Create an account and select your permit type. New construction, addition, remodel, and accessory-structure permits each have separate application paths.
  3. Upload your plan set as PDFs. Most counties, including Morgan County, reject non-PDF uploads outright, so convert scanned or CAD files before submitting.
  4. Attach required supporting documents. This usually means a site plan, stamped structural drawings, and an engineering or soils report if your lot requires one.
  5. Sign and, if requested, notarize the application before it moves into the review queue.
  6. Pay the plan review deposit. This charge is due at submittal, separate from the final permit fee assessed later.

Pro Tip: Verify every fee notice directly through the official portal or a system like Teller before paying anything. Salt Lake City’s building department specifically warns homeowners to confirm invoices through the portal rather than trusting an emailed link, since scam notices have targeted permit applicants.

What Do Permits Cost, and How Long Do They Take?

Standard residential reviews take about 3 to 10 working days in most counties, according to guidance from Cache County. Complex projects, like a custom home with engineered foundations or a multi-system remodel, can stretch to 30 to 45 working days once revisions and re-reviews are factored in.

Fees arrive in two waves. You pay a non-refundable plan review deposit at submittal, then a final permit fee calculated from your project’s valuation or square footage once the plans clear review. Morgan County’s process reflects this two-part structure, and many jurisdictions layer on a 1% state surcharge that gets forwarded to the state building code division.

Permits expire. Most Utah jurisdictions cancel a permit if work doesn’t start within a specific period after issuance, and inactive projects can lapse similarly. Refund rules on an expired or withdrawn permit vary by county, so ask before you assume any deposit comes back.

  • Plan review deposit: paid at submittal, non-refundable
  • Final permit fee: based on project valuation, paid before permit issuance
  • State surcharge: roughly 1% in many jurisdictions
  • Expiration: commonly 180 days without active work

What Inspections and Certifications Do You Need for a Certificate of Occupancy?

A permit gets you started. A Certificate of Occupancy is what lets you actually move in, and it depends on a sequence of inspections plus a handful of third-party certifications that catch homeowners off guard late in the build.

  1. Footing and foundation inspection, before any concrete gets covered
  2. Framing inspection, once the structural shell is up
  3. Rough-in inspections for electrical, plumbing, and mechanical systems, before drywall goes up
  4. Energy compliance testing, including a blower door test that measures air leakage
  5. Final inspection, covering everything from egress windows to smoke detectors

Before that CO gets released, most jurisdictions also want a soils compliance letter, insulation and energy certificates, and, depending on your exterior finish, a stucco or termite certification. Washington City’s submittal requirements spell out this documentation list, and missing even one item can hold up occupancy for weeks.

Pro Tip: Never cover work before its inspection is signed off. Utah County’s building department is blunt about the consequences: inspectors can require you to remove finished drywall or flooring to verify what’s underneath, which costs far more than the delay of waiting for the inspector.

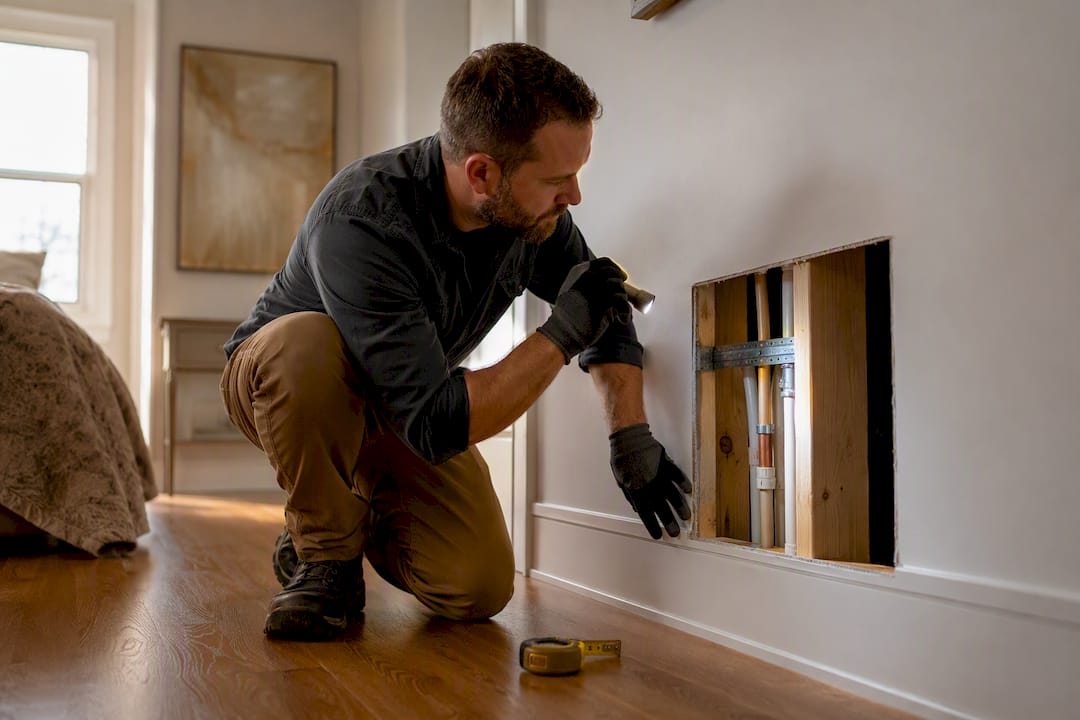

Inspector checking work behind finished drywall

How Do You Verify a Contractor’s License in Utah?

Run every contractor’s license and insurance certificate through the Division of Occupational and Professional Licensing before signing anything, and cross-check it against your local building department’s contractor list. A licensed contractor typically manages permit submission, plan revisions, and inspection scheduling directly, which takes that entire administrative load off your plate.

Owner-builder status is legal in many Utah counties, but it puts full code-compliance responsibility on you. That includes tracking every inspection deadline and correcting plan issues yourself.

  • Check license status and standing through DOPL before signing a contract
  • Confirm general liability and workers’ compensation coverage
  • Ask who will physically pull the permit and manage inspections
  • Understand that owner-builder status shifts compliance risk onto you

What Causes Permit Delays, and How Do You Avoid Them?

Incomplete submissions cause more delays than any code issue. Missing a stamped signature, uploading a plan set in the wrong file format, or leaving out an engineering report sends your application back to the intake queue instead of forward into review. Morgan County and similar jurisdictions reject non-PDF files outright, which is an easy problem to avoid if you check the portal’s specs before uploading.

  • Use the jurisdiction’s checklist before submitting, not after a rejection notice
  • Confirm file format requirements (almost always PDF) ahead of upload
  • Schedule inspections as soon as each construction phase completes, not after
  • Budget time for third-party certifications rather than scrambling for them at the end

Pro Tip: Treat any unsolicited payment request, especially a wire transfer, as a red flag. Legitimate fee notices come through the jurisdiction’s own portal, never through a cold email demanding immediate payment.

The Local Builder’s View on Permit Coordination

The Local Builder's View on Permit Coordination — overview diagram

Permit delays rarely come from the code itself. They come from plans that don’t match what an inspector expects to see on site. A local builder’s experience shows the pattern holds up on nearly every project: the fewer corrections a plan set needs during review, the faster the whole timeline moves.

Virtual consultations and 3D renderings do more than help clients visualize a kitchen or a new wing. They force structural and mechanical details into the plan before submission, which means fewer resubmittals once a county reviewer starts marking up drawings. A plan-ready submission on day one is worth more than a fast portal.

— Jake

Get Permit Support for Your Room Addition

Homeowners planning a room addition in Washington or Iron County often lose more time to plan corrections and missed inspections than to actual construction. Some builders manage the permit application, plan submission, and inspection scheduling for room addition projects, so you’re not the one chasing down a soils letter or re-uploading a PDF at the last minute.

Prestigioushome

Explore the room addition services some builders offer in Washington and Iron Counties, then request a consultation to walk through your project’s permit requirements before you file anything with your local building department.

Official Permit Resources to Bookmark

Before you start an application, save these references. Your county or city building department page lists local checklists and portal links, whether that’s a Citizen Access Portal system, ProjectDox, or a direct email submission process. Utah’s adopted building code explains the statewide standards local departments enforce, useful when you need to check a specific requirement against the code itself rather than guessing. Building codes exist to enforce minimum safety standards for structural and life-safety systems, which is worth remembering when a requirement feels like an inconvenience rather than a protection.

Sources

Conclusion

The construction industry is at the cusp of a technological revolution. Embracing these trends not only enhances efficiency and sustainability but also opens up new possibilities for innovation. Whether you’re planning a project or exploring career opportunities in construction, understanding these trends will keep you ahead of the curve.
