A realistic bathroom remodel timeline typically ranges broadly from the initial consultation through to the final walkthrough, depending greatly on scope and complexity. The range is that wide because scope drives everything: a cosmetic refresh (new fixtures, paint, vanity swap) wraps in 1–2 weeks of on-site work, while a full gut remodel with layout changes can run 6–12 weeks of construction alone. What most homeowners miss is that pre-construction, meaning design, selections, permits, and ordering materials, adds a notable time period before demolition begins.
The construction window itself varies substantially depending on scope. But the schedule is almost always won or lost before demo day. Permit approval alone can take anywhere from one week to several months depending on your municipality. Custom vanities, specialty tile, and frameless shower glass routinely carry 2–8 week lead times. Order those items late and your bathroom sits gutted while you wait.
- Cosmetic refresh: 1–2 weeks on-site, 1–2 weeks pre-construction
- Mid-range remodel (tile, vanity, fixtures): 3–4 weeks on-site, 2–4 weeks pre-construction
- Full gut with layout changes: 6–12 weeks on-site, 4–6 weeks pre-construction
Pro Tip: The two most overlooked schedule risks are material lead times and inspection gates. Lock your tile, vanity, countertop, and glass selections before demo day, and call your local building department to ask about current permit turnaround times before you set a start date.
Table of Contents
- What changes a bathroom remodel timeline: the primary drivers
- What do sample timelines look like for different project scopes?
- Phase-by-phase construction timeline: what happens and how long each step takes
- What causes the most delays, and how do you prevent them?
- How does your budget affect how long the remodel takes?
- Pre-project checklist and staging tips to keep the schedule moving
- How Prestigioushome plans and sequences projects to meet timelines
- Key Takeaways
- What contractors wish homeowners knew about remodel timelines
- Prestigioushome makes your remodel timeline predictable from day one
- Useful sources and where to check permits
What changes a bathroom remodel timeline: the primary drivers
Six factors move your project toward the fast or slow end of the range. Understanding them before you sign a contract is how you avoid surprises mid-project.
Scope and layout changes are the biggest single variable. Moving a toilet, relocating a shower drain, or adding a window triggers structural and plumbing work that can add weeks. A like-for-like replacement of fixtures in the same positions is the fastest path through construction.

Permit and inspection timing is the most underestimated driver. Permit approval can take one week to several months depending on your municipality, and rough-in inspections must pass before walls can close. Miss an inspection window and you may wait days or weeks for a re-inspection slot.
Material lead times are where projects quietly fall apart. Custom or semi-custom items ordered late are the most common cause of a gutted bathroom sitting idle. The table below shows typical lead-time ranges for the items that most often stall projects.

| Material | Typical Lead Time |
|---|---|
| Stock vanity (big-box) | 1–5 days |
| Semi-custom vanity | 3–6 weeks |
| Custom frameless shower glass | 2–4 weeks after templating |
| Specialty or imported tile | 2–6 weeks |
| Countertop fabrication | 1–3 weeks after templating |
Hidden repairs discovered at demo are common and hard to predict. Subfloor rot, galvanized plumbing, outdated wiring, and mold behind tile walls show up regularly once demolition starts. Budget a contingency window of several days and a contingency fund of 10–15% of your project cost to absorb these without derailing the schedule.
Subcontractor scheduling matters more than most homeowners realize. Plumbers, electricians, and tile setters each have their own calendars. A gap of even a day or two between trades compounds quickly across a multi-week project, especially during peak season (spring and summer).
Homeowner decision speed is the one variable entirely in your control. Change orders mid-project, late tile selections, or second-guessing a vanity choice after it has been ordered can each add days to weeks. Locking every selection before demo is the single most effective thing you can do to protect your schedule.
Quick mitigation for each driver:
- Layout changes: Finalize the floor plan before design is complete; price out plumbing moves before committing.
- Permits: Apply as early as possible; ask your contractor to pull permits the day design is approved.
- Materials: Order everything with a lead time over one week during the design phase, before demo is scheduled.
- Hidden repairs: Set a contingency budget and give your contractor pre-authorization to handle minor discoveries without a formal change order.
- Trade coordination: Ask your contractor for a written schedule showing each trade’s start and end dates before work begins.
- Decision speed: Make all selections, including grout color and hardware finish, before demo day.
What do sample timelines look like for different project scopes?
Three project types cover the vast majority of bathroom remodels. Here is how each one typically breaks down.
| Project Type | Scope Summary | Pre-Construction | On-Site Construction | Total Range |
|---|---|---|---|---|
| Cosmetic refresh | Paint, fixtures, vanity swap, no tile or plumbing moves | 1–2 weeks | 1–2 weeks | 2–4 weeks |
| Mid-range remodel | New tile, vanity, fixtures, shower surround, same layout | 2–4 weeks | 3–4 weeks | 5–8 weeks |
| Full gut with layout changes | Complete demo, new layout, custom tile, glass, all new plumbing/electrical | 4–6 weeks | 6–12 weeks | 10–18 weeks |
A few things extend these ranges beyond the table. Any structural work, such as removing a load-bearing wall or raising a ceiling, adds at minimum one to two weeks. Projects requiring multiple permit approvals (plumbing, electrical, and structural separately) can stack inspection windows. High-end or imported materials with longer lead times push pre-construction out further.
For homeowners with a single bathroom, the on-site construction window is the period your household is without a working bathroom. A mid-range project running three to four weeks on-site means three to four weeks of alternative arrangements. Plan for that before demo day, not after.
When a home has multiple bathrooms, contractors sometimes stagger work to keep one functional. That approach can extend the overall project calendar slightly but preserves daily life considerably.

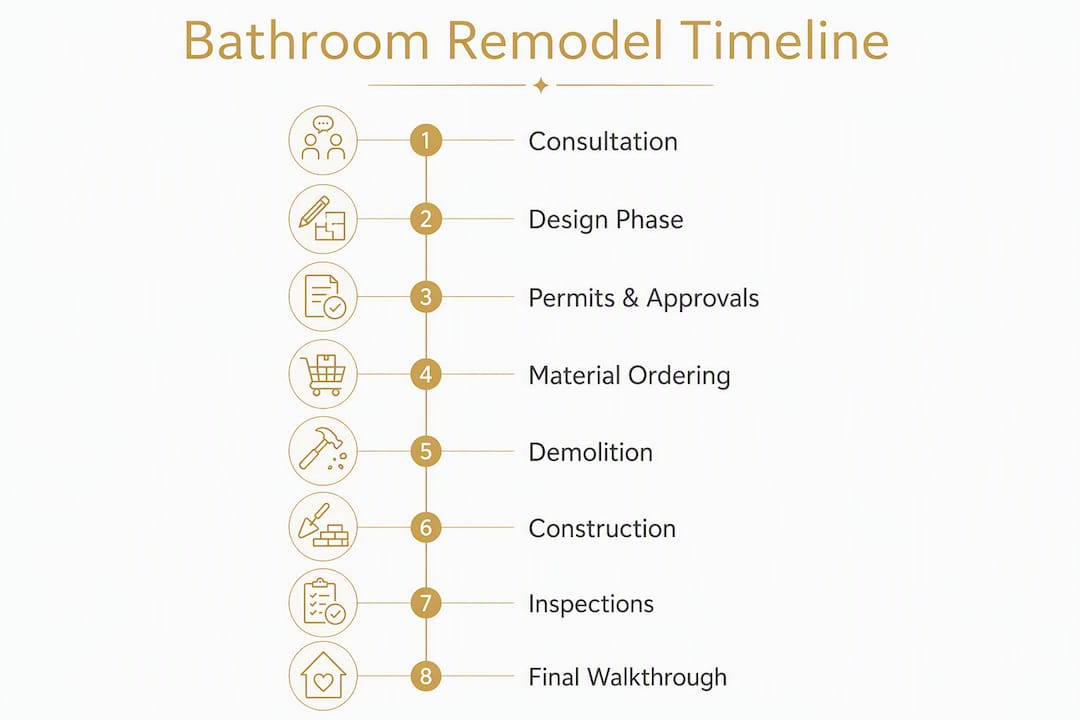

Phase-by-phase construction timeline: what happens and how long each step takes
The construction sequence for a bathroom remodel is not flexible. Each phase has dependencies, and skipping or rushing steps creates rework that costs far more time than the shortcut saved. Here is the canonical order with realistic durations.
-
Protection and staging (half a day): Floors, doorways, and adjacent rooms are protected. Materials already on-site are staged. Short, but skipping it means dust and debris throughout the house.
-
Demolition and discovery (1–3 days): Tile, fixtures, drywall, and flooring come out. This is when hidden problems appear. Subfloor rot, mold, old galvanized pipes, and outdated wiring all surface here. Budget time and money for at least minor discoveries.
-
Structural repairs (1–5 days, if needed): Subfloor replacement, framing corrections, or window modifications happen before any rough-in work. Duration depends entirely on what demo revealed.
-
Rough-in plumbing and electrical (4–7 days): New drain and supply lines are run; electrical circuits are added or relocated. This phase must be complete before the rough-in inspection.
-
Rough-in inspection (scheduling varies): The building inspector must approve rough-in work before walls close. In some jurisdictions this is a same-week appointment; in others it takes one to two weeks to schedule. Do not close walls before this passes.
-
Substrate and waterproofing (2–4 days): Cement board or tile-ready panels go up; waterproofing membrane is applied to the shower and wet areas. Waterproofing must cure fully before tile begins. Rushing this step is one of the most common causes of long-term failures.
-
Tile installation (5–10 days): Tile work is often the longest single on-site phase, and complexity matters. Large-format tiles, intricate patterns, and niche details all add time. Grout and sealer add additional cure days after installation before the shower can be used.
-
Countertop templating (1 day on-site, then 1–3 weeks fabrication): The countertop fabricator templates after the vanity is set and tile is complete. Fabrication typically takes one to three weeks. This is a critical-path dependency: nothing in the countertop sequence can start until the vanity is in place.
-
Vanity and cabinetry installation (1–2 days): Vanity cabinet goes in before countertop templating. Confirm the vanity has arrived and been inspected for damage before this day arrives.
-
Glass measurement and fabrication (1 day on-site, then 2–4 weeks fabrication): Custom frameless shower glass cannot be templated until tile is complete and cured. The fabricator measures, then glass is cut and finished off-site. This step commonly adds two to four weeks to the finish phase and is the most frequent source of end-of-project delays.
-
Final fixtures (1–2 days): Toilet, faucets, shower valve trim, towel bars, mirrors, and lighting are installed after tile, countertop, and glass are in place.
-
Paint and trim (1–2 days): Final paint, baseboard, and door casing go in after fixtures to avoid damage.
-
Punch list and final inspection (1–3 days): Walk the space with your contractor, note any items needing correction, and schedule the final building inspection if required. Most punch lists close within a day or two.
Pro Tip: Order your shower glass and countertop fabricator early, even before demo. Give them your design drawings and ask for a lead-time commitment. The glass fabricator will still need to template after tile is done, but knowing their current backlog lets you schedule the project end date accurately instead of discovering a three-week wait after tile is finished.
What causes the most delays, and how do you prevent them?
Most schedule slippage is predictable. The causes repeat across nearly every project, and most of them have a straightforward fix if you act before demo day.
Late material orders are the leading cause of a gutted bathroom sitting idle. Locking in tile, vanities, countertops, and glass during the design phase is the single most effective tactic to avoid idle gaps. A custom vanity ordered after demo can add three to six weeks to the project. Order it when design is confirmed.

Failed or delayed inspections can stall a project for days or weeks. Schedule your rough-in inspection the same day rough-in work is complete. Do not wait. In busy municipalities, inspection slots fill quickly, and a failed inspection means rescheduling from the back of the queue.
Hidden demo discoveries are common enough to budget for. Subfloor rot, mold, galvanized pipes, and knob-and-tube wiring all require remediation before the project can continue. The EPA’s mold cleanup guidance is a useful reference if mold is found during demo. Pre-authorize your contractor to handle minor discoveries up to a set dollar amount without a formal change order so the schedule does not stall while paperwork is processed.
Homeowner indecision and change orders are entirely controllable. Changing tile after it has been ordered, swapping a vanity after rough-in, or adding a heated floor mid-project each trigger delays and cost increases. The fix is simple: make every decision before demo day and commit to it.
Trade coordination conflicts happen when subcontractors are not sequenced tightly. Ask your contractor for a written schedule before work begins. Confirm that each trade knows their start date and that materials will be on-site before they arrive.
Seasonal peak workloads affect contractor and inspector availability. Spring and summer are the busiest seasons for remodeling in most U.S. markets. Starting a project in late fall or winter often means faster permit turnaround and more flexible contractor schedules.
Pre-construction checklist to lock in schedule-critical items before demo:
- Finalize all design decisions, including tile, grout color, vanity, fixtures, and hardware
- Confirm lead times for every item with a lead time over one week
- Place orders for all long-lead materials
- Apply for permits and confirm expected approval timeline with the building department
- Schedule rough-in inspection in advance if your jurisdiction allows it
- Arrange temporary bathroom access for single-bath households
- Give contractor pre-authorization for minor contingency repairs up to an agreed dollar threshold
- Add a 10–20% time buffer to your expected on-site construction window
A single late custom item, particularly shower glass or a countertop, can add two to three weeks to an otherwise finished project. The glass fabricator cannot template until tile is done and cured; the countertop fabricator cannot template until the vanity is set. Neither can be rushed once the sequence starts. The only way to shorten those waits is to choose fabricators with short backlogs before demo day.
How does your budget affect how long the remodel takes?
Budget and timeline are connected, but not always in the direction homeowners expect. More money does not automatically mean a faster project. Here is how common budget ranges typically map to scope and schedule.
Around $5,000: This budget covers a cosmetic refresh. Think new vanity, toilet, faucets, mirror, paint, and light fixture, with no tile work and no plumbing moves. On-site work runs one to two weeks. Pre-construction is minimal because most items are stock and available immediately. For a deeper look at what different budgets realistically cover, the bathroom remodel budget guide breaks down ranges by scope.
Around $10,000: A modest mid-range remodel. New tile in the shower or on the floor, a new vanity with a stone countertop, updated fixtures, and possibly a new tub or shower unit. On-site construction runs two to four weeks. Pre-construction adds two to four weeks for selections, ordering, and permitting. Total: four to eight weeks.
$25,000 and up: A full gut remodel with quality materials, custom tile work, frameless glass, and potentially a layout change. On-site construction runs six to twelve weeks. Pre-construction adds four to six weeks. Total: ten to eighteen weeks. At this budget level, custom and imported materials are common, and their lead times drive the schedule as much as the construction work itself.
A few nuances worth knowing:
- Higher budgets can speed some things. Stock materials from a big-box store are available in days; paying for expedited fabrication on countertops or glass is possible but adds cost.
- Custom and high-end materials almost always have longer lead times than stock alternatives, so a larger budget can paradoxically extend the pre-construction window.
- Expedited shipping for specialty tile or fixtures is available from some suppliers but can add hundreds of dollars to material costs.
- Regional pricing in Utah and the Mountain West differs from national averages. What $10,000 buys in St. George or Cedar City may differ from what the same budget covers in a high-cost coastal market.
The honest answer to “Is $5,000 enough?” is: enough for a cosmetic refresh, not enough for tile work or layout changes. “What does a $10,000 remodel look like?” typically means new tile, a new vanity, updated fixtures, and a fresh look without moving walls or drains.
Pre-project checklist and staging tips to keep the schedule moving
Getting to demo day fully prepared is what separates a smooth project from a chaotic one. These steps belong in the two to four weeks before construction starts.
Homeowner prep tasks:
- Finalize every design decision and get them in writing with your contractor
- Confirm that all ordered materials have shipping confirmations and expected delivery dates
- Verify permits are approved and posted before demo begins
- Clear the bathroom of all personal items, medications, and valuables
- Remove artwork and fragile items from adjacent rooms and hallways
- Clear a path from the exterior entry to the bathroom for material delivery and debris removal
- Arrange temporary bathroom access: a second bathroom in the home, a gym membership, or a portable toilet for longer projects
Staging and logistics:
- Designate a staging area (garage, spare room) for delivered materials before installation
- Schedule deliveries to match the installation sequence: tile before tile day, vanity before vanity day, glass after tile is complete
- Protect hardwood floors and carpet in adjacent rooms with rosin paper or plastic sheeting
- Confirm with your contractor who is responsible for debris removal and when it happens
Contractor responsibilities vs. homeowner tasks:
Your contractor handles permit posting, trade scheduling, inspection coordination, and material staging within the work area. Your job is to make decisions on time, keep the access path clear, and be reachable for questions. The most common homeowner-caused delay is being unavailable when a quick decision is needed mid-project.
For single-bath households, the on-site construction window is the hardest part of the project. Plan the alternative bathroom arrangement before demo day, not the morning after. A mid-range project runs three to four weeks; a full gut can run six to twelve weeks. That is a long time to rely on a neighbor’s shower.
How Prestigioushome plans and sequences projects to meet timelines
Prestigioushome follows a structured process designed specifically to prevent the gaps and idle periods that extend most bathroom remodels. The sequence starts well before demo day.
The process begins with a consultation and design phase, where the team uses virtual consultations and 3D renderings to finalize the layout, material selections, and scope before any work is scheduled. This is not a formality. Getting every selection confirmed in 3D before ordering means there are no surprises when materials arrive and no last-minute changes that trigger reorders.
Once design is confirmed, Prestigioushome verifies lead times for every long-lead item, including tile, vanity, countertop, and glass, and places orders before scheduling demo. This is the step that prevents the most common source of project downtime: a gutted bathroom waiting on a backordered vanity or a glass fabricator with a three-week queue.
Permitting is handled by the team, not delegated to the homeowner. Permit applications go in as soon as design is approved, and the team tracks approval status so the construction schedule can be set accurately. Inspection gates, including rough-in and final, are built into the project calendar from the start.
During construction, a coordinated schedule keeps each trade sequenced correctly. Plumbers, electricians, tile setters, and finish carpenters each know their start date and what needs to be complete before they arrive. That coordination is what prevents the two-day gaps between trades that quietly add a week to a project.
Prestigioushome serves homeowners in Washington and Iron Counties, Utah, including St. George and Cedar City. The team’s experience with local building departments means permit timelines are estimated accurately, not optimistically.
Key Takeaways
A full bathroom remodel typically spans ten to eighteen weeks from first consultation to final walkthrough, including both pre-construction and on-site construction stages, and the schedule is almost always determined before demo day.
| Point | Details |
|---|---|
| Separate pre-construction from on-site work | Pre-construction adds 4–6 weeks before demo; plan for it as part of the total timeline. |
| Order long-lead items during design | Vanities, specialty tile, and glass often require several weeks for fabrication and delivery, and late ordering of these items is a common cause of delays. |
| Treat inspections as schedule gates | Rough-in inspection must pass before walls close; schedule it the day rough-in is complete. |
| Add a contingency buffer | Budget 10–20% extra time and 10–15% extra cost for hidden discoveries and minor delays. |
| Prestigioushome manages the full sequence | From design and 3D renderings through permitting and trade coordination, Prestigioushome handles the steps that most commonly stall homeowner-managed projects. |
What contractors wish homeowners knew about remodel timelines
The single most damaging misconception homeowners bring to a bathroom remodel is that the construction window is the whole timeline. It is not. The weeks spent on design, selections, ordering, and permitting are where most projects are either set up for success or quietly sabotaged. A contractor who starts demo before every material is confirmed and every permit is approved is setting the project up for gaps, and gaps are expensive.
Late selections are the most controllable delay, and they are also the most common. Homeowners who arrive at the design meeting with a clear sense of what they want, and who commit to those choices without revisiting them, consistently finish faster than those who treat selections as an ongoing conversation. Grout color, hardware finish, mirror size: these feel like small decisions, but each one that lands mid-project creates a ripple.
The other thing contractors rarely say directly: living through a remodel is harder than most homeowners expect. Dust travels further than you think. Noise starts earlier than you want. A single-bath household without a working bathroom for three to four weeks is a real logistical challenge, not a minor inconvenience. The homeowners who handle it best are the ones who planned for it before demo day, not the ones who assumed it would be fine.
Change orders are not inherently bad. Unexpected discoveries happen, and sometimes a scope change is the right call. The problem is unplanned change orders that arrive without a pre-authorized budget or decision process. Agreeing with your contractor upfront on a threshold, say, any single change under a set dollar amount can proceed without a formal approval, keeps the schedule moving when minor issues surface.
One more thing: chasing a bargain on a long-lead item almost always costs more time than it saves money. A specialty tile that ships from overseas in six weeks instead of two weeks from a domestic supplier might save a few hundred dollars and add a month to your project. The math rarely works out in the homeowner’s favor.
Prestigioushome makes your remodel timeline predictable from day one
Bathroom remodels go sideways for predictable reasons: materials ordered too late, permits applied for too slowly, inspections not scheduled in advance, and trades left to coordinate themselves. Prestigioushome eliminates each of those failure points through a managed process that covers design, ordering, permitting, and construction scheduling as a single coordinated sequence.

For homeowners in Washington and Iron Counties, Utah, that means a realistic schedule set at the start, not revised repeatedly mid-project. The team uses 3D renderings to lock selections before demo, verifies every lead time before scheduling construction, and handles permit tracking so inspection gates do not catch anyone off guard. Whether you are planning a mid-range tile-and-vanity update or a full gut remodel, the process is the same: no guesswork, no idle weeks waiting on a backordered item.
Request a free quote to get a realistic timeline and scope estimate for your bathroom project. You can also explore the full range of remodeling and construction services Prestigioushome offers across Washington and Iron Counties.
Useful sources and where to check permits
For permit requirements and inspection scheduling:
Start with your local municipal building department. Most Utah cities and counties have online portals where you can check permit requirements, submit applications, and schedule inspections. Washington County and Iron County both have building department resources accessible through their official government websites. Call the building department directly to ask about current permit turnaround times before setting a project start date.
For a detailed breakdown of what triggers a permit requirement in a bathroom remodel, the bathroom permit guide covers Utah-specific requirements and inspection timing.
For further reading on timelines and sequencing:
- Bathroom Remodel Timeline: How Long Does It Really Take? | Foreverbuilt — real-world timelines by project type with week-by-week breakdowns
